Pyongyang General Hospital Construction Progress (February-December 2020)

Pyongyang General Hospital Construction Progress (February-December 2020)

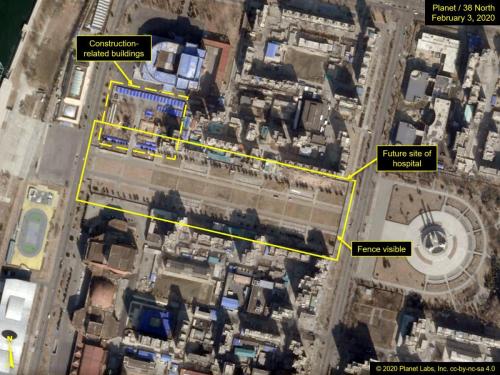

Site of Pyongyang General Hospital, February 3, 2020.

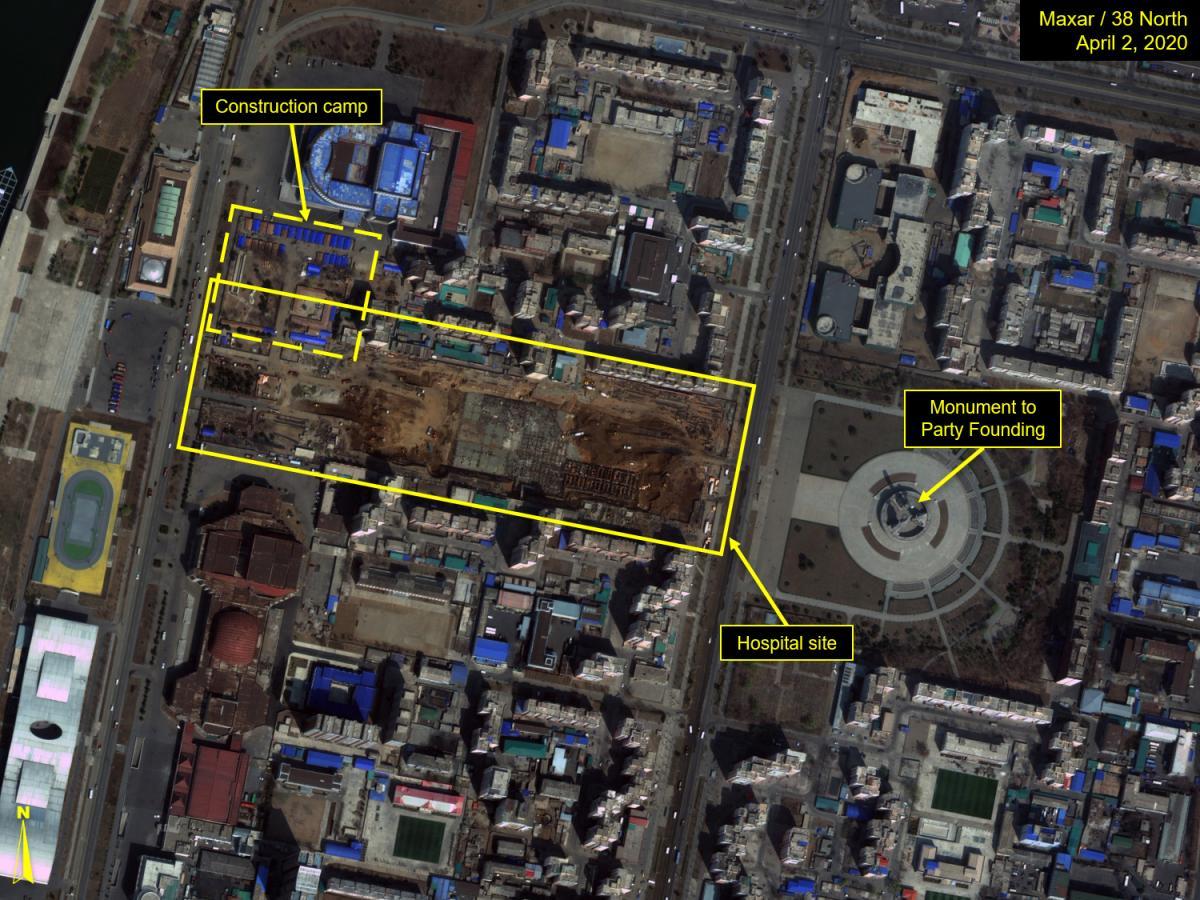

Foundation work of hospital, April 2, 2020.

Significant construction progress, July 20, 2020.

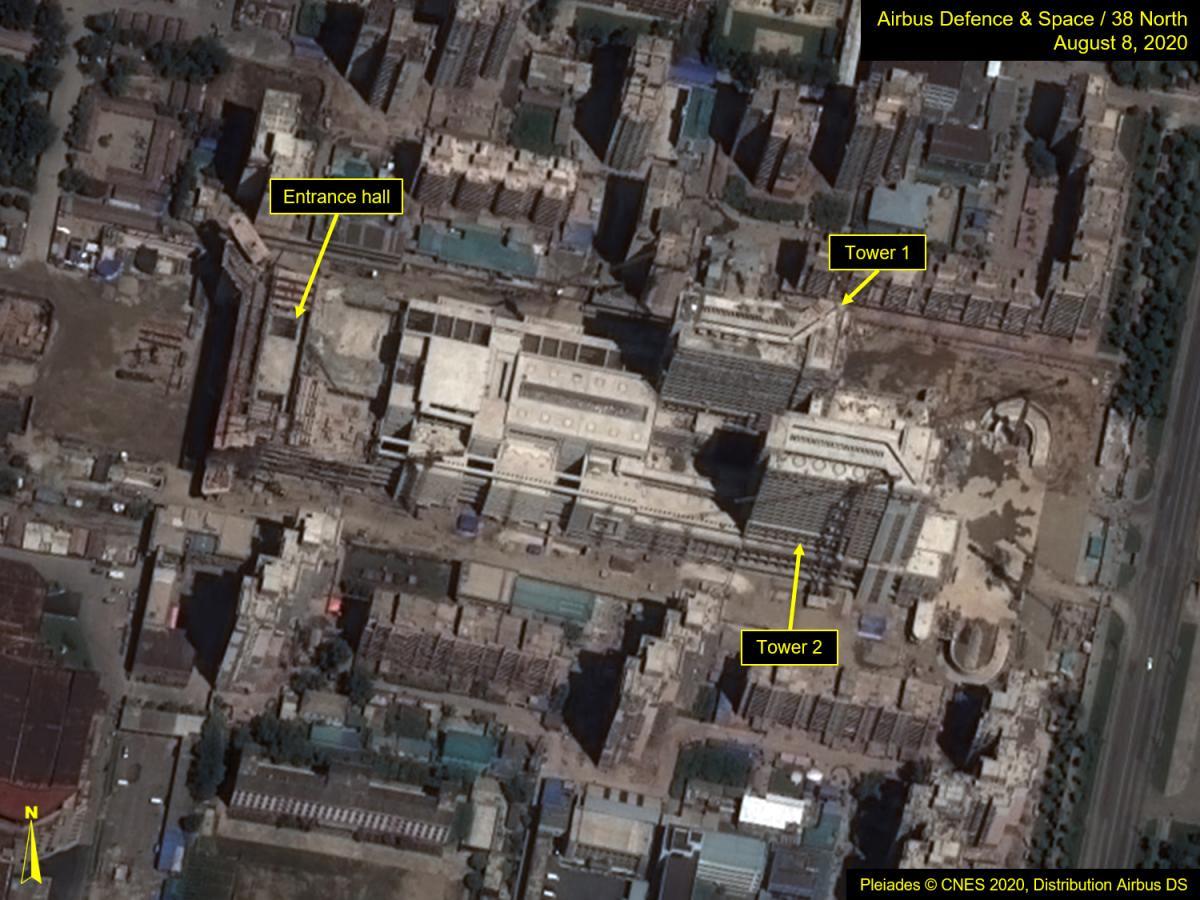

Overview of hospital construction, August 8, 2020.

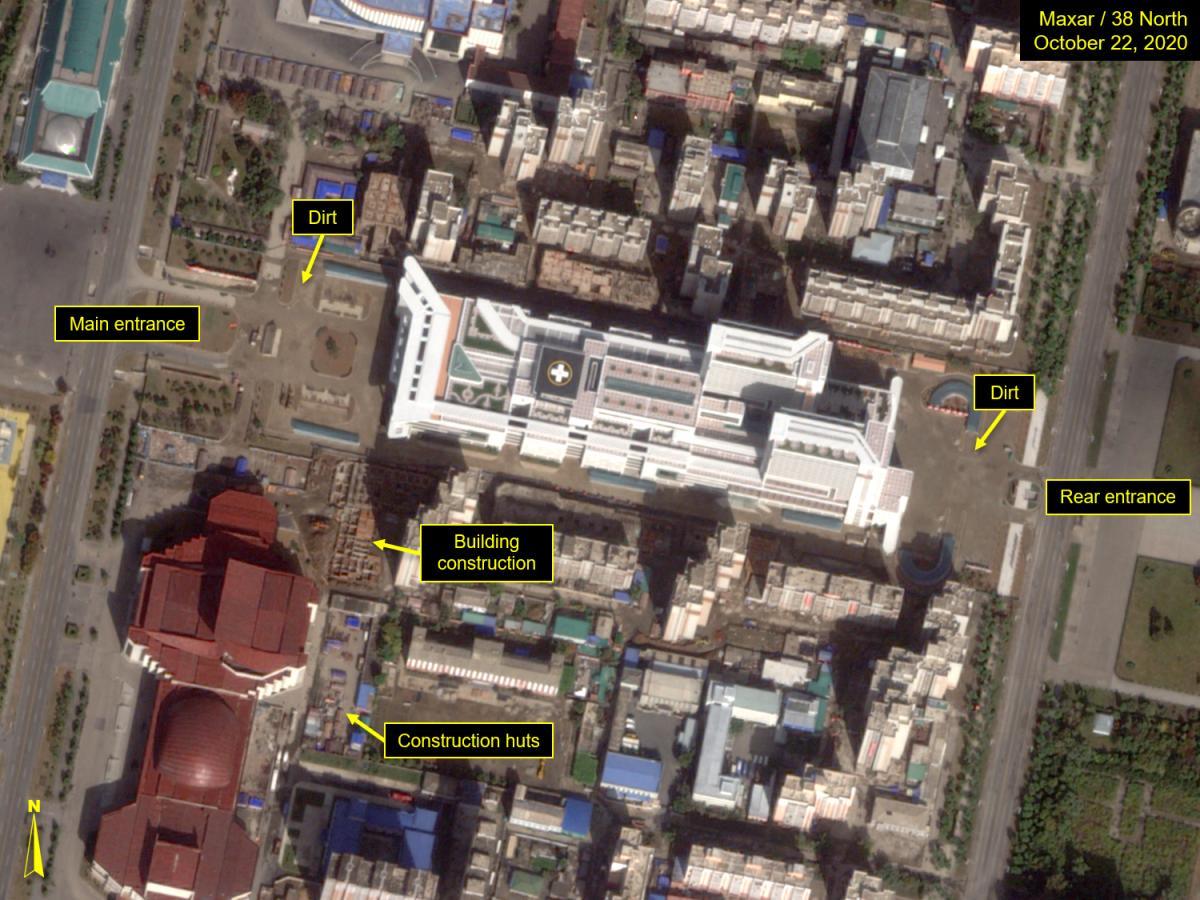

Hospital exterior appears complete, October 22, 2020.

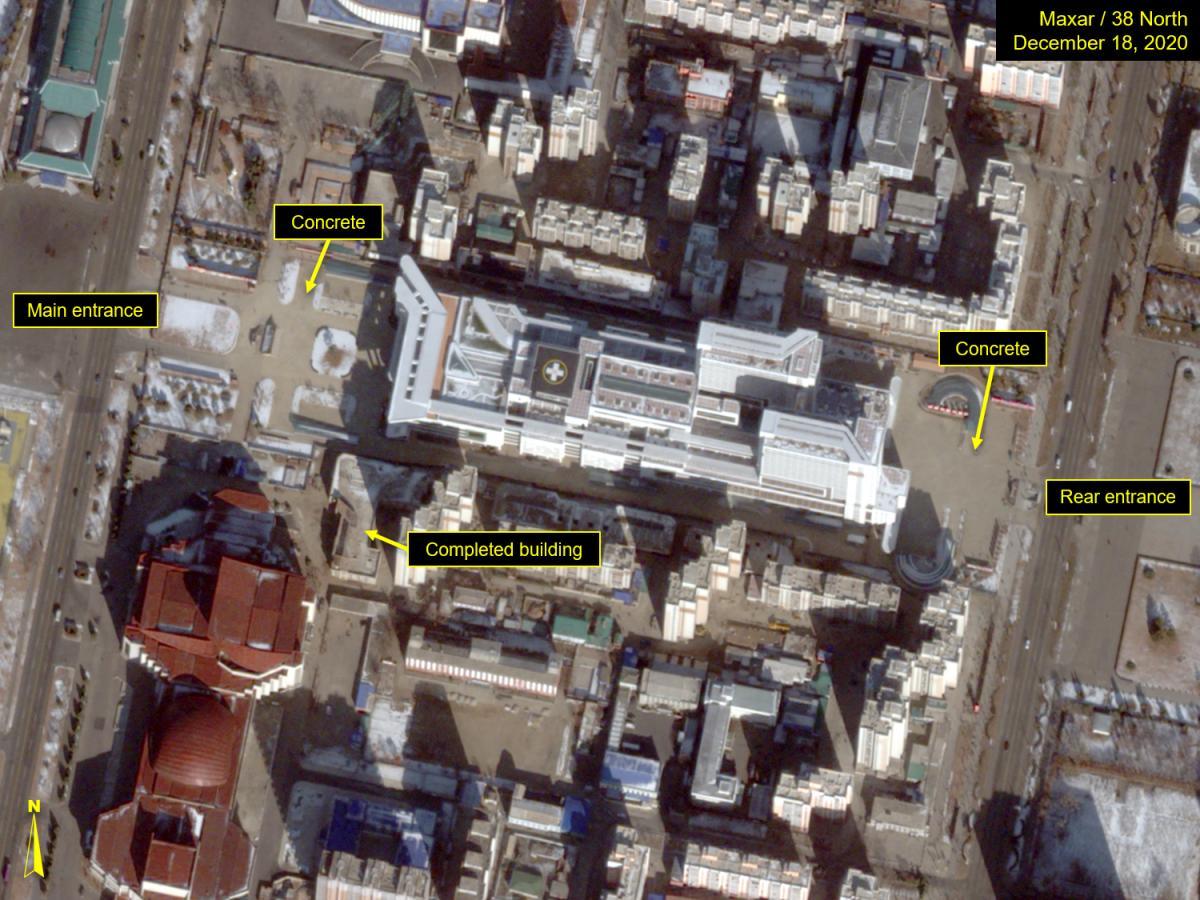

Area paved and landscaped, December 18, 2020.
